Operating outside DP equipment class 2 requirements
- DP Event
- Published on 3 September 2019
- Generated on 22 February 2025
- DPE 03/19
- 2 minute read
Incident
Jump to:

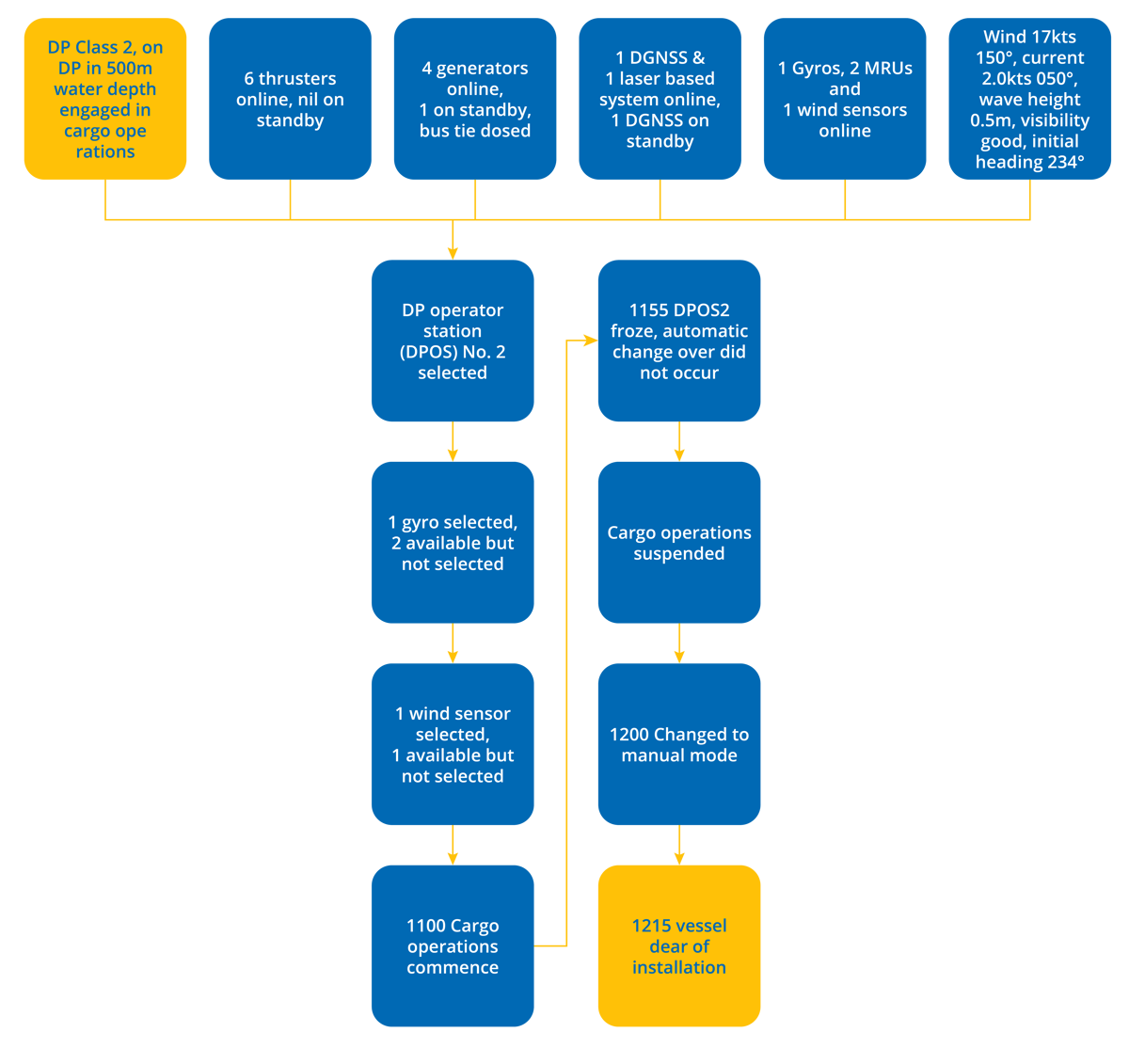

There were not enough PRSs or sensors online to meet requirements for equipment class 2 DP operations.

Comments
Although DP checklists were completed, the availability of the standby operator station was not confirmed. The most probable cause for DPOS2 to freeze and not auto changeover was traced to a faulty IO controller on DPOS2.
The vessel replaced the controller with a spare held on-board. At the time of the loss of DPOS2, Gyro feed was not available in any one of the controllers. Various position reference systems (PRS) and sensors were deselected and that caused the vessel to go in ‘dead reckoning’ when losing the IO controller on DPOS2.
Gyro 1 and 3 were both serviced at the next port call. Vessel simulated auto changeover of the DP Operating system and bump-less transfer was confirmed after maintenance.
Considerations
- There were not enough PRSs or sensors online to meet requirements for equipment class 2 DP operations.
- The setup of the vessel and the content of the incident report suggests insufficient understanding and training for both the DP control system and the DP operation.
- There seems to be some confusion about ‘operator station’ and ‘controller’.
- The report states that the possible reason that the DP operator stations did not automatically change-over was a faulty I/O controller. A faulty I/O controller should have activated an alarm.
- If the single gyro online was not available to the DP controllers, it is unlikely that the controller/operator station will change-over to a controller that also does not have an available gyro input. This depends on the system architecture and the DP control system FMEA should have been used as part of the investigation process.
- Test of the changeover function between DPOS consoles and DPC controllers should be part of the field arrival check list.
- The report is inconclusive and suggests that further investigation and testing is required.
Latest DP incidents
-
Thorough preparation is key
With 4 of 8 diesel generators running and connected to a closed ring bus, and 7 of the 8 thrusters selected to DP, a DP equipment class 3 MODU was set up in Green mode whilst on standby.
DPE 03/24
5 November 2024
Incident
-
There – but not really there
This DP event occurred on a DP equipment class two supply vessel whilst carrying out cargo operations on the starboard side alongside the asset and working at the lee side in the drift-off position.
DPE 03/24
5 November 2024
Incident
-
Equipment Class 3, even if you operate as 'Class 2'
This case study examines a DP incident on an equipment class 3 multi-purpose vessel while operating in good conditions.
DPE 03/24
5 November 2024
Incident
-
Line of sight
This case study covers events onboard a DP equipment class 2 vessel whilst holding position in a turbine field, with three position reference systems selected into DP – DGPS, HPR and Fanbeam.
DPE 03/24
5 November 2024
Incident
-
DP Drill Scenario
DP emergency drill scenarios are included to assist DP vessel management, DPOs / Engineers, and ETOs in conducting DP drills onboard.
DPE 03/24
5 November 2024
Incident
The case studies and observations above have been compiled from information received by IMCA. All vessel, client, and operational data has been removed from the narrative to ensure anonymity. Case studies are not intended as guidance on the safe conduct of operations, but rather to assist vessel managers, DP operators, and technical crew.
IMCA makes every effort to ensure both the accuracy and reliability of the information, but it is not liable for any guidance and/or recommendation and/or statement herein contained.
Any queries should be directed to DP team at IMCA. Share your DP incidents with IMCA online. Sign-up to receive DP event bulletins straight to your email.
